Project Owner: City of Aurora
Engineers: HDR and GEI
Contractor: BTrenchless
Manufacturers/Suppliers: Akkerman Inc., TT Technologies, Permalok – A Northwest Pipe Co., HOBAS Pipe USA and Pipeco
Value of Trenchless Project (US$): $15,354,000
Aurora Water’s First Creek Interceptor project ensures a reliable, sustainable and efficient wastewater conveyance system for Aurora and neighboring communities.
The trenchless components of this project also demonstrate exemplary engineering and construction practices, as well as the deployment of innovative solutions to varying and unpredictable site conditions. For these reasons, the First Creek Interceptor project was selected as the 2024 Trenchless Technology New Installation project of the Year Runner-up.
“We’re super excited to be considered in the running for Project of the Year,” says Andrea Long, P.E., principal engineer of Aurora Water. “This project has been part of a regional master plan and it’s been years in the making and in detailed design since January 2020. For it to come to fruition is exciting on our part.”
As Long notes, the First Creek Interceptor project was first identified in 2017 as part of a regional master plan for Metro Water Recovery’s (Metro) First Creek Sanitary Basin. The plan called for a new interceptor that would convey waste-water from Aurora and its neighboring communities to Metro’s new Northern Treatment Plant in Brighton, Colorado.
Metro Water Recovery designed its Northern Treatment Plant to support growth in the Northern Aurora and other communities such as Brighton, Commerce City, Thornton, and unincorporated Adams County and Denver. “This gravity system allows for two benefits,” says Long. “One, it allows Metro Water Recovery to offload flows from its main facility and sent it to the new treatment plant. And second, Aurora benefits because we could take four lift stations offline, saving long term capital and maintenance money and pretty much have a maintenance-free system.”
The First Creek Interceptor (FCI) system, comprising Segments 0 through 1E, begins at Aurora’s Prologis Lift Station and terminates at the Metro-owned regional Second Creek interceptor. The FCI system eliminates the need for Aurora’s Prologis Lift Station, First Creek Lift Station, Second Creek Lift Station and High Point Lift Station. Both trenchless and open-cut methods were used for the project.

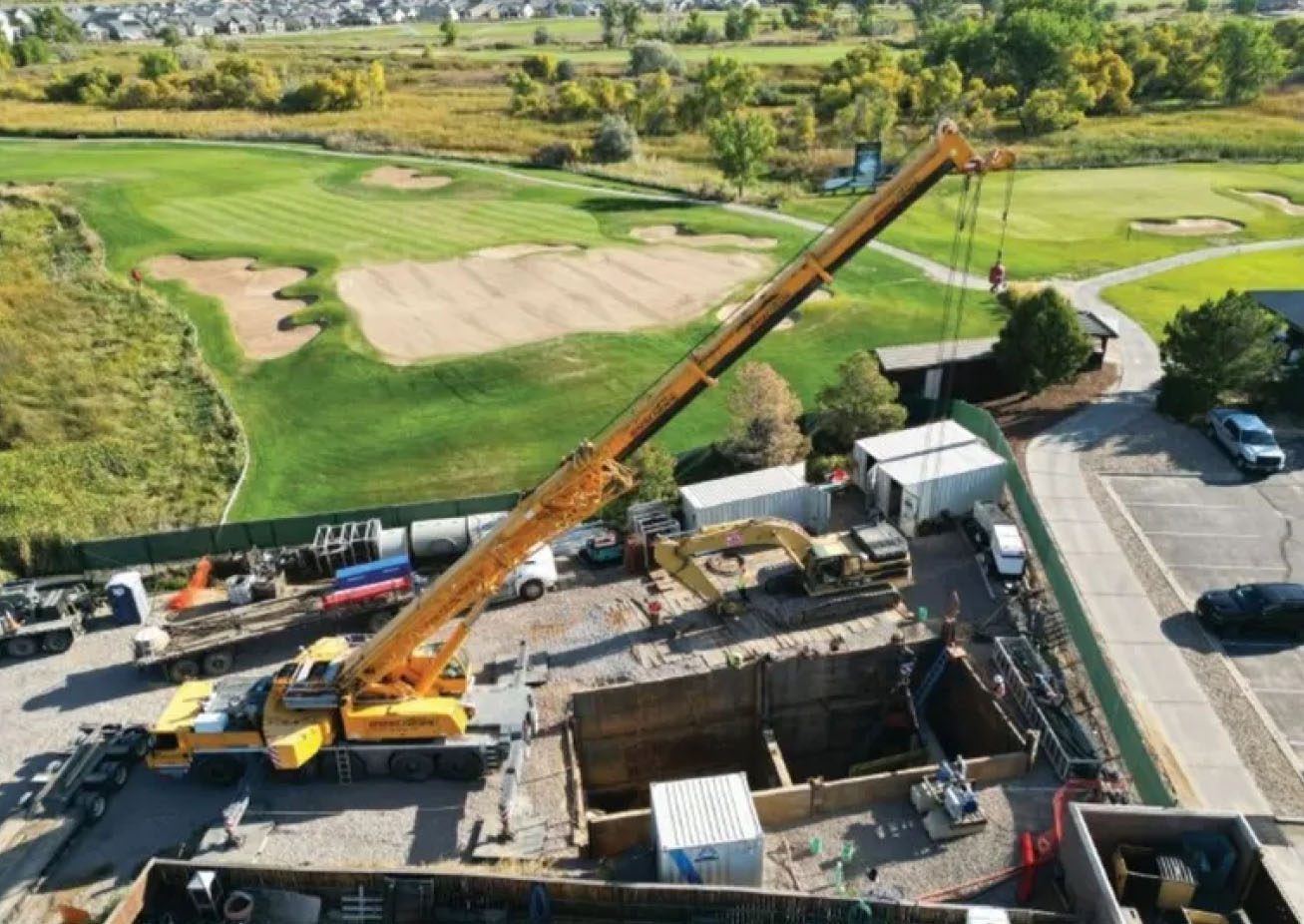

The Final segments of this gravity system, FCI Segments 1B, 1C and 1D, encompass approximately 21,300 lf of 42-in., 2,000 lf of 12-in., and 160 lf of 36-in. diameter gravity interceptors. The depths of the interceptors vary from 12 to 40 ft and cross several municipal boundaries. The project included six trenchless crossings under creeks, sensitive areas, arterial streets and a golf course. The trenchless work was completed by Henderson, Colorado-based BTrenchless, a division of BT Construction, Inc.
Multiple trenchless techniques were approved for bidding, with the following methods being selected for each crossing:
During the construction phase, several newly installed utilities were discovered. In two specific areas, the present of these utilities posed a significant challenge to open-cut crossings, necessitating their relocation.
The required relocations threatened to disrupt the construction timeline significantly. However, through collaborative brainstorming, BTrenchless proposed a value-engineered solution to hand tunnel the problematic crossings:
“We looked at several methods there [hand tunneled segments], but at the end of the day the hand tunnels made the most sense based on the soil conditions that we had seen in the area,” says Shawn August, senior project manager of BTrenchless. He notes that the shorter hand tunnels had the best and most likely chance of success.
August adds that in addition to discovering the newly installed utilities, the most challenging part of the First Creek Interceptor project were the varying geotechnical conditions. He notes that in some sections the calcium sediment was so high that they had to adjust their slurry mix. Normally they would add calcium to the slurry, but in this instance, there was more than enough in the material.
“The ground conditions were tough,” he says. “You could move 20 ft and have completely different soils. There were a lot of clays, calcium sediment, sand and gravel, and the dewatering was also substantial on this project.”
Long adds that the contractor faced several instances of split-faced conditions that ended up being considered a change in field conditions despite having a full geotechnical report ahead of the work. “How the geology actually moved vs. what we thought it would do was completely different,” she says.
This project not only achieved its primary objective of providing a reliable, sustainable, and efficient wastewater conveyance system but also demonstrated exemplary engineering practices, construction practices and innovative solutions under challenging conditions.
The construction began in late 2022 and the trenchless components were substantially complete in June 2024. The new pipeline will be online by the end of 2024.
